A failed Con Edison inspection isn’t just a paperwork delay; it’s a fast track to a dark property and compounding daily fines that can start at $1,000 for residential owners. You’re likely staring at the May 2026 edition of the “Specifications for Electric Installations” and feeling overwhelmed by the technical jargon surrounding Con Edison meter pan upgrade requirements. It’s frustrating when you just want your power secured and your building compliant without the stress of a rejection. We understand that the “Blue Book” can be a maze for even the most diligent property managers, especially with the recent 2026 code updates.

This guide simplifies the technical and legal landscape so you can secure your permits and pass your NYC DOB inspection on the first attempt. You’ll learn exactly how to handle mandatory outdoor metering rules for row houses and the new 50% upfront permit fee structure mandated as of December 2025. We provide a clear roadmap through the latest smart meter communication standards and the transition to three-phase service for loads exceeding 400 amps. By the end of this checklist, you’ll have the professional clarity needed to ensure your NYC infrastructure is safe, legal, and powered by New York’s Brightest.

Key Takeaways

  • Identify the common infrastructure triggers for a service upgrade, including the installation of high-demand equipment like EV chargers and central AC systems.
  • Master the specific Con Edison meter pan upgrade requirements for 2026, including mandatory UL listings and NEMA 3R ratings for all outdoor enclosures.
  • Navigate the complex five-step approval sequence starting with the non-negotiable “Load Letter” to ensure your project avoids unnecessary service delays.
  • Use our pre-inspection checklist to verify that your installation uses correct conduit materials like Rigid Metal Conduit and meets all physical mounting standards.
  • Discover how professional oversight by a licensed Master Electrician simplifies the Con Ed liaison process and secures a “Pass First Time” result for your property.

Understanding Con Edison Meter Pan Upgrades in NYC

The meter pan is the heavy-duty metal enclosure that serves as the critical handoff point between Con Edison’s grid and your building’s internal electrical system. It houses the electric meter, which measures your energy consumption. In New York City, this hardware must meet rigorous standards to ensure safety and accurate billing. While Con Edison owns the actual meter, the property owner is responsible for the meter pan, the service entrance cables, and the conduit. Meeting the latest Con Edison meter pan upgrade requirements is essential for any property owner looking to modernize their infrastructure or increase their power capacity.

Several modern upgrades frequently trigger the need for a new meter pan. If you are converting a building from a 100-amp service to a 200-amp service, the existing pan is likely undersized and legally non-compliant. Common triggers include:

  • Installation of Level 2 EV charging stations.
  • Converting fossil-fuel heating to high-efficiency heat pumps.
  • Adding central air conditioning to a multi-family property.
  • Converting a single-family home into a multi-unit dwelling.

Con Edison enforces strict equipment standards because the NYC environment is uniquely demanding. High-density housing and aging infrastructure mean that a single equipment failure can impact dozens of neighbors. By following the NYC Electrical Code and Con Ed’s engineering specifications, you protect your property from fire hazards and avoid the legal headaches of Class 1 hazardous violations.

Why Your NYC Property Needs a Meter Pan Upgrade

Safety is the primary driver for hardware updates. Many older NYC properties still rely on “bootleg” or un-permitted meter installations that lack proper grounding or weatherproofing. If your meter enclosure shows signs of heavy rust, corrosion, or heat discoloration, it is a ticking time bomb. An undersized meter pan cannot handle the thermal stress of modern electrical loads like heat pumps or electric dryers. As of July 31, 2024, Con Edison no longer provides single-phase service for installations exceeding 400 amps. If your project requires higher capacity, you must upgrade to a three-phase system, which requires entirely different meter socket hardware to remain code-compliant.

Con Edison’s Role in Your Service Upgrade

The “Specifications for Electric Installations, 2026 Edition” is the definitive rulebook for every project in the five boroughs. Often called the Blue Book, this document dictates everything from the height of the meter to the type of conduit allowed. Con Edison does not work in a vacuum; they coordinate closely with the NYC Department of Buildings (DOB). You cannot get your power turned on until a licensed Master Electrician files a certification with the DOB and Con Ed confirms the installation matches their specific Con Edison meter pan upgrade requirements. The team at Triumph Electrical Contracting Inc. handles this entire liaison process, ensuring your hardware is approved and your service is activated without the typical 90-day delays seen with inexperienced contractors.

Technical Specifications for Con Edison Meter Pans

Selecting the right hardware is the first step in ensuring your property passes inspection the first time. All outdoor enclosures must carry a UL listing and a NEMA 3R rating to withstand New York’s variable weather conditions. These enclosures must also accommodate the transition to Advanced Metering Infrastructure (AMI). The 2026 edition of the Con Edison Meter Installation Requirements provides specific tables for approved meter sockets and current transformer (CT) cabinets. If you’re installing an indoor meter room or a below-grade facility, you must now include conduits for antenna placement to ensure the smart meter can communicate with the Con Ed grid.

Wire sizes and lug requirements vary significantly between 100, 200, and 400 amp installations. For a 200-amp service, you typically need 3/0 copper or 250 kcmil aluminum conductors. It’s important to remember that as of July 31, 2024, Con Edison no longer provides single-phase service for installations exceeding 400 amps. Any load larger than this requires a three-phase service upgrade, which involves more complex hardware and different Con Edison meter pan upgrade requirements. Our technicians ensure every lug is torqued to manufacturer specifications to prevent the thermal failures common in rushed installations.

Mounting Height and Location Standards

Con Edison maintains a “Golden Rule” for meter placement to ensure their technicians can safely access the equipment. The center of the electric meter must be positioned between 3 and 5 feet above the finished grade. You must also maintain a clear working space of at least 3 feet in front of all metering equipment. Indoor installations require a horizontal minimum clearance of 36 inches from any gas meter. Code strictly prohibits installing meter pans in bathrooms, over gas lines, or in any location where they are subject to excessive vibration or physical damage.

Approved Equipment and Lever Bypass Requirements

All equipment must be selected from the Con Edison Approved Meter Equipment List (MEP). A critical component for modern compliance is the lever bypass mechanism. In 2026, Con Edison mandates that all 200-amp residential meter sockets include a manual lever bypass to allow for meter testing or replacement without disconnecting the building’s power supply. For multi-family buildings, multi-gang meter banks must be used, and each position must be clearly and permanently labeled with the corresponding apartment number. If you’re unsure which hardware fits your specific building layout, our team can help you select the right code-compliant service upgrade components to avoid costly rejections.

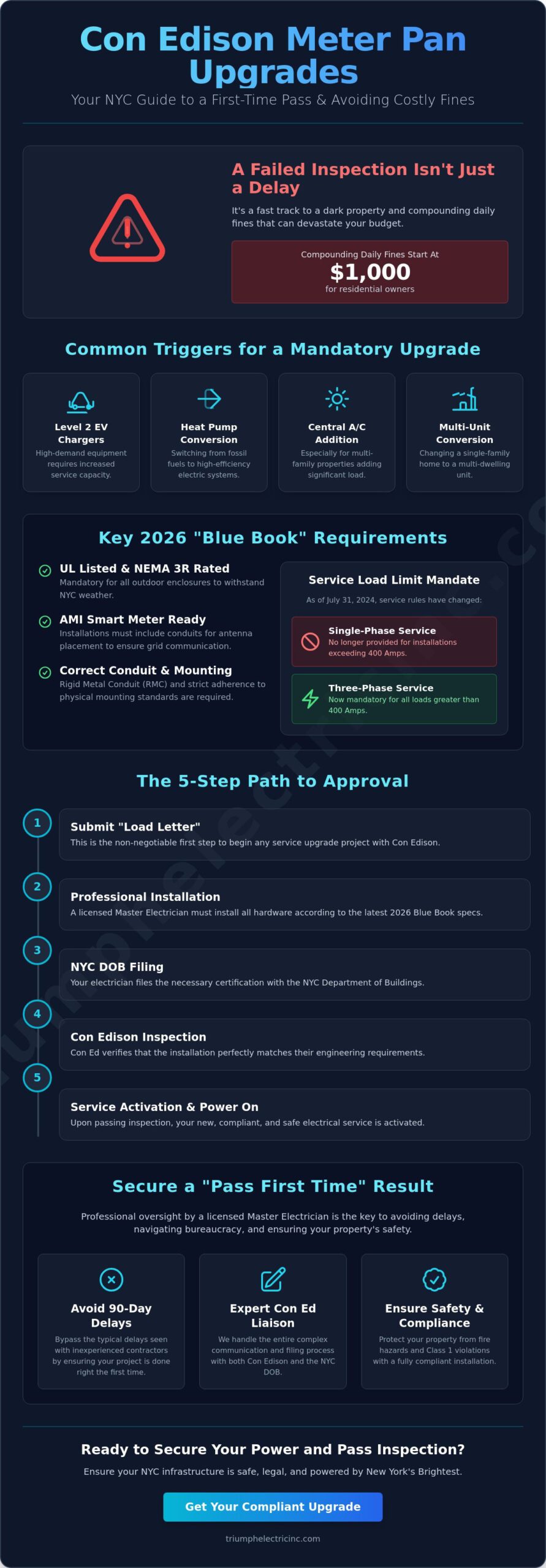

Con Edison Meter Pan Upgrade Requirements: 2026 NYC Compliance Checklist

Securing the right hardware is only half the battle. The administrative side of Con Edison meter pan upgrade requirements involves a strict five-step sequence that must be followed to the letter. This process begins with the Load Letter and concludes with the final Con Ed “turn-on.” If you skip a step or submit incorrect data, you risk a 90-day delay or an outright rejection from the utility’s engineering department. Triumph Electrical Contracting Inc. handles this bureaucracy daily, ensuring your project moves from the filing stage to the finish line without unnecessary service interruptions.

The Load Letter is your non-negotiable first step. This document calculates your building’s total electrical demand to justify the requested service size. If you’re modernizing a multi-family property or adding high-draw equipment, this is where you prove the grid can safely handle your new load. Once approved, we coordinate the “Cut and Reconnect” process. This requires a precisely scheduled outage where Con Edison disconnects the power so we can safely install the new code-compliant hardware. In many cases, a meter upgrade is the primary requirement for NYC electrical violation removal. If the DOB finds an illegal “bootleg” meter or an un-permitted installation, you must bring the entire service entrance up to current NYC Electrical Code standards.

Filing the Load Letter and Work Request

Calculating demand is a precise task that leaves no room for error. We use the Con Edison Project Center to submit and track every work request. In 2026, typical lead times for an engineering review range from four to eight weeks, depending on the complexity of the service entrance. You should also prepare for the NYC DOB fee updates enacted in December 2025. These rules now require a 50% upfront payment of the total permit fee at the time of filing, with a minimum cost of $130. Our team manages these filings to ensure your project stays on schedule and remains fully transparent.

The Critical Role of a Licensed NYC Master Electrician

You cannot legally perform a meter pan upgrade as a DIY project or with an unlicensed handyman. Only a licensed electrician in NYC has the authority to pull the necessary permits through the DOB NOW portal. As your Master Electrician, Triumph Electrical Contracting Inc. takes full responsibility for the “Self-Certification” of the meter pan. This professional oversight ensures your installation aligns perfectly with our Con Edison Service Upgrade Guide. We stand by our work with a “Pass First Time” guarantee, removing the stress of potential rejections or hazardous code violations.

Comprehensive Pre-Inspection Checklist for Meter Upgrades

Before scheduling your final walkthrough, you must verify that every physical component aligns with the 2026 Con Edison meter pan upgrade requirements. The enclosure must be level, plumb, and securely fastened to the building structure using lead anchors or high-strength masonry fasteners. We don’t accept flimsy mounting because persistent vibration can lead to loose connections and hazardous arcing. The physical integrity of the box is the first thing an inspector checks, so the installation must be rock-solid.

Your choice of conduit is equally critical for a successful sign-off. For service entrance runs, you must use Rigid Metal Conduit (RMC) or Intermediate Metal Conduit (IMC); Electrical Metallic Tubing (EMT) is generally prohibited for these high-exposure outdoor areas. Ensure the service head is positioned well above the point of attachment to prevent rainwater from traveling down the cables and into the enclosure. For multi-meter installations in apartment buildings, each pan must have a permanent, legible label. Sharpie markers or adhesive tape will result in an immediate inspection failure; we use factory-engraved or stenciled identification to ensure long-term compliance.

Clearance and Accessibility Requirements

Con Edison technicians require unobstructed access to your equipment at all times for maintenance and emergency shut-offs. The “3-foot rule” mandates that you keep a clear radius around the meter, free of shrubs, fences, trash bins, or storage sheds. If your meter is located behind a locked gate, you must provide a Con Ed-approved lock or ensure a representative is present for the inspection. Additionally, you must maintain a mandatory 3-foot horizontal clearance from any gas meter or regulator. Failing to respect this buffer zone is one of the most common reasons for a rejected application in high-density NYC neighborhoods.

Grounding and Bonding Standards for 2026

Grounding is your building’s primary defense against lightning strikes and power surges. Your Grounding Electrode Conductor (GEC) must be sized correctly based on your service amperage; a 200-amp service typically requires a #4 copper wire. We ensure this conductor is bonded directly to the building’s main water service pipe on the street side of the water meter. For 2026, the NYC Electrical Code mandates the installation of two supplemental 8-foot copper-bonded ground rods spaced at least 6 feet apart to provide a redundant path to earth. To ensure your property meets these life-safety standards, contact our team to schedule a code-compliant meter installation that passes the first time.

Professional Meter Pan Installation with Triumph Electrical Contracting Inc.

Managing a service upgrade in New York City requires more than just technical skill; it demands a deep understanding of utility bureaucracy. Triumph Electrical Contracting Inc. handles the entire Con Ed liaison process from start to finish. We manage the Load Letter submissions, coordinate the “Cut and Reconnect” schedules, and ensure all hardware meets the latest Con Edison meter pan upgrade requirements. Our primary goal is to minimize downtime for your tenants or business operations. We understand that every hour without power is an hour of lost revenue or residential stress. Our team works efficiently to get your building back on the grid legally and safely.

The transition to a new service entrance should be seamless. We don’t believe in cutting corners or guessing on code compliance. Our electricians follow a methodical workflow that aligns with both the NEC and the specific engineering standards of the 2026 Blue Book. By choosing a partner who understands the local regulatory environment, you avoid the common pitfalls that lead to project stalls and cost overruns. We provide the legitimacy and security your NYC infrastructure deserves.

Passing Con Edison Inspection the First Time

Our “Pass First Time” guarantee isn’t just a slogan; it’s the result of our rigorous internal standards. Before any official inspector arrives at your property, we perform a comprehensive 50-point pre-inspection audit on every meter pan installation. We verify torque settings, clearance distances, and conduit integrity to ensure the work is flawless. If Con Ed issues an “Advisory” or “Deficiency” notice on a project, we respond immediately to resolve the technicality. We’ve built professional, long-standing relationships with Con Ed field inspectors across the five boroughs. This rapport allows us to move through the 2026 compliance landscape with speed and precision. When you hire New York’s Brightest, you’re investing in a team that knows exactly what the city’s inspectors are looking for.

Emergency Violation Removal and Rapid Response

Electrical emergencies don’t wait for business hours. If a rusted meter pan or a hazardous violation has triggered an immediate power shut-off, you need a rapid response to restore safety. Triumph Electrical Contracting Inc. provides 24/7 emergency service repairs to fix critical issues and clear violations professionally. Our crews are stationed throughout the city to reach your property quickly, whether you’re in Long Island City or a high-rise in Manhattan. We provide upfront, transparent pricing with no hidden costs. To start your project today, you can get an accurate estimate from a licensed electrical contracting firm that understands the specific Con Edison meter pan upgrade requirements for your property type.

Secure Your NYC Property with Code-Compliant Power

Mastering the technical specifications for lever bypass sockets and navigating the 2026 DOB fee structure are the primary hurdles for any property manager. Aligning your hardware with current Con Edison meter pan upgrade requirements is the only legal way to avoid hazardous violations and service rejections. Whether you’re upgrading for EV charging or removing a legacy violation, precision is non-negotiable in the five boroughs. Triumph Electrical Contracting provides the seasoned expertise needed to handle these high-stakes projects professionally.

As a Licensed NYC Master Electrician (#12345), we maintain an A+ rating for NYC DOB violation removal and offer 24/7 emergency service across all five boroughs. We take pride in being New York’s Brightest and stand by our promise of passing inspection the first time. Don’t let outdated hardware or confusing utility paperwork put your building at risk. Contact Triumph Electrical today for a code-compliant Con Edison meter pan upgrade. We’re ready to secure your infrastructure and deliver the peace of mind you deserve.

Frequently Asked Questions

Can I buy my own meter pan for a Con Edison upgrade?

You can purchase your own hardware, but it must appear on the Con Edison Approved Meter Equipment List (MEP). Many property owners buy generic pans that lack the required lever bypass or NEMA 3R weatherproofing. This mistake leads to an immediate inspection failure. It’s safer to have your licensed electrician supply the equipment to ensure it meets every 2026 engineering standard for your specific borough.

How much does a Con Edison meter pan upgrade cost in NYC?

Total costs depend on the service amperage, the length of the conduit runs, and the current NYC DOB filing fees. As of February 2026, the DOB requires a 50% upfront payment of the permit fee at the time of filing, with a minimum of $130. Because every building has unique structural challenges, a professional on-site estimate is the only way to get a fixed price for a code-compliant installation.

What is a lever bypass meter pan and why is it required?

A lever bypass is a manual handle inside the enclosure that allows a technician to maintain power to the building while the meter is removed. Con Edison mandates this for 200-amp residential services and all commercial meters to ensure safety during testing. This hardware is a primary part of Con Edison meter pan upgrade requirements to prevent accidental power outages for tenants during routine utility maintenance.

How long does Con Edison take to approve a service upgrade request?

The approval process typically ranges from 30 to 90 days. This timeline includes the engineering review of your Load Letter and the scheduling of the “Cut and Reconnect” appointment. If your project requires street-side excavation or a transformer upgrade, the wait time can extend toward the 90-day mark. We use the Con Edison Project Center to track your application daily and push for the earliest possible completion.

Does Con Edison provide the meter pan or do I have to buy it?

Con Edison provides the actual electric meter, but the property owner is responsible for providing the meter pan. You are also responsible for the service entrance cables, the weatherhead, and the conduit. All customer-owned equipment must comply with the 2026 edition of the Specifications for Electric Installations. If the hardware doesn’t match the utility’s approved list, they will refuse to install the meter and energize your building.

What happens if my meter pan fails a Con Edison inspection?

If the installation fails, the inspector will issue a deficiency notice and leave the service de-energized. You must then hire a licensed Master Electrician to correct the issues, which often involve improper grounding or incorrect mounting heights. This failure can result in your building being without power for several additional days. Our “Pass First Time” process is designed specifically to avoid these costly and stressful service delays.

Can a meter pan be installed inside my NYC basement?

Indoor installations are permitted but must meet strict accessibility and safety standards. You must maintain 36 inches of horizontal clearance from any gas meter and provide 24/7 access for utility staff. Under the 2026 code, indoor meter rooms also require dedicated conduits for AMI smart meter antennas. These antennas ensure the smart meter can transmit data through thick foundation walls to the Con Edison communication network.

How do I know if my existing meter pan is code-compliant?

Check for visible rust, loose mounting bolts, or the absence of a lever bypass on a 200-amp service. If your equipment was installed before the 2026 Blue Book revisions, it may no longer meet Con Edison meter pan upgrade requirements. Older “round” meter sockets are almost always non-compliant for modern service upgrades. A professional audit by a licensed firm is the most reliable way to identify illegal “bootleg” installations or hazardous wear.
